Whiteminwhill Energy Park
Voltalia UK Ltd is exploring land at Whiteminwhill for a potential energy park located approximately 0.9km south of Barrhill, South Ayrshire.
Contact us

Public Consultation

Thank you to everyone who shared their insights, feedback and suggestions during our first round of consultation between Monday 17th November 2025 and Monday 15th December 2025

We would like to thank the local community and those who attended our two public consultation events, held in Girvan and Pinwherry. We hope you found the events informative and that you were able to provide your feedback on the proposals.

The consultation is now closed, but you can still view the materials on our consultation page: Whiteminwhill Energy Park | Voltalia Share Your Feedback

We are currently reviewing all feedback received and using this to inform our proposals, ongoing technical assessments, and consultation with statutory stakeholders and the local authority. We will share how we’ve considered feedback in our plans at the next public consultation in 2026.

If you have any questions, please do not hesitate to contact us via: whiteminwhill@voltalia.com.

Solar capacity

Up to approximately 50 megawatt (MW)

Wind capacity

Potentially 5 turbines with a generating capacity of up to 50MW

Battery energy capacity

Up to approximately 100MW

Project Status

Scoping Opinion received

Operational Period

Up to 40 years

About the Project

Voltalia UK Ltd (‘Voltalia’) is proposing to develop Whiteminwhill Energy Park, located approximately 0.9km south of Barrhill in South Ayrshire, Scotland.

Voltalia submitted a Scoping Report to the Scottish Government’s Energy Consent Unit (ECU) in June 2025. The Report aims to present an initial overview of potential environmental receptors within the Site and vicinity of the Proposed Development, and to determine the likelihood of any significant effects on receptors caused by the Proposed Development. This allows the ECU and consultees to provide an informed opinion of the Proposed Development, as well as to provide advice and suggestions for the methodology of assessments included in, and the structure of, an EIA Report. A Scoping Opinion was received from the ECU in August 2025.

Site Location

The site is located approximately 0.9km south of Barrhill in South Ayrshire, Scotland.

Overview of the Planning Process

Section 36 Consent

Proposals to construct, extend or operate an onshore electricity generating station with a capacity of over 50MW requires the consent of Scottish Ministers under section 36 of the Electricity Act 1989.

As the project is proposed to generate over 50MW, it will be subject to a Section 36 consent application submission to the Scottish Government’s Energy Consents Unit (ECU). Whether to grant consent or not for the project will be determined by Scottish Ministers.

Environmental Impact Assessment

An Environmental Impact Assessment (EIA) seeks to identify and assess the potential environmental impacts of a project. As the project falls under Schedule 2 of the Electricity Works (EIA) (Scotland) Regulations 2017, an EIA is required to be submitted as part of the application submission.

In June this year, we submitted a request for a Scoping Opinion to the Scottish Government’s Energy Consents Unit (ECU), with South Ayrshire Council acting as an important Statutory Consultee.

ECU’s feedback and ongoing discussion with stakeholders have provided us with specialist advice and suggestions for the methodology of our environmental assessments. We also want other stakeholders, including local residents and businesses to view our plans and provide their feedback.

These steps will then inform our EIA Report, which we will prepare and submit as part of the Section 36 consent application.

Project Timeline

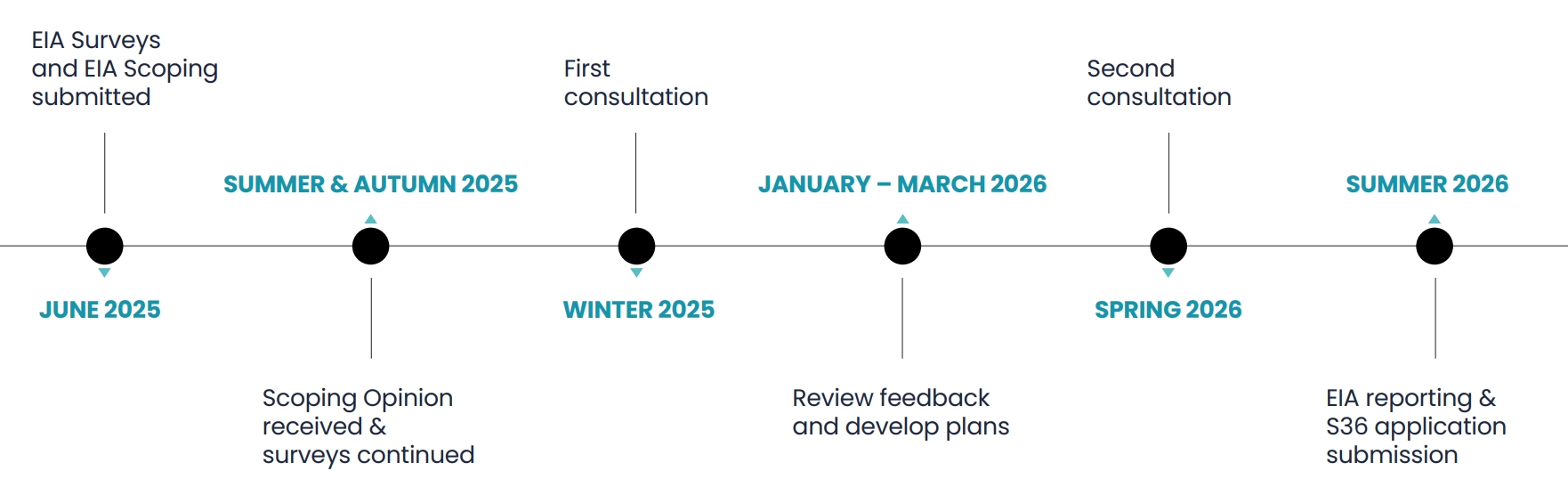

Whiteminwhill Energy Park Project Timeline

We will be posting further updates here as the project progresses. If you’d like to receive regular updates, please contact us via whiteminwhill@voltalia.com.

Document Library

Click on the links below to view and download key project documentation:

Community Benefits

As a renewable energy developer and provider, we want each of our projects to not only help improve the global environment by reducing carbon emissions but also help to improve the local environment.

We are committed to providing environmental, social and economic benefits to the communities who host our projects and encourage communities to engage with us on their priorities and aspirations. We are proposing to establish a Community Benefit Fund for the project and are keen to work with the local community to shape the fund and focus on local priorities.

We would love to hear from local residents, groups and businesses on how the project could benefit you. If you would like to share your ideas, please contact whiteminwhill@voltalia.com.

Community Benefit Fund

Working with local suppliers

Enhancing habitat for species

Educational visits to local schools and the project
